Emergency Services Expansion update – May 9, 2025

May 9, 2025




Crews are making significant progress with the construction of Zone Charlie. The interior framing is now complete except for the demising wall. The exam rooms have been painted and the headwall installation is underway.

Construction Update

The final drywall in Zone Charlie is being installed, and finishing touches, including paint, ceiling installation, and bathroom tiling, are being added to the space. Additionally, the installation of case work, wall protections, and floor preparation is underway.

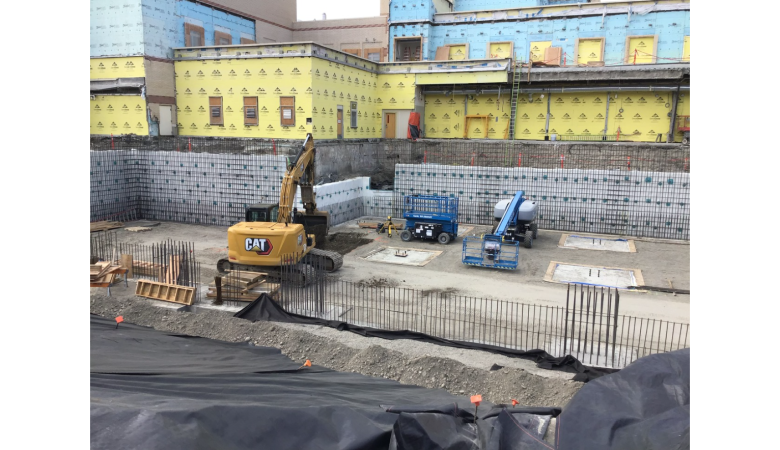

Outside, gravel fill, compaction, and waterproofing continue in preparation for the tower. The installation of helical piles will begin at the end of next week, and the pouring of elevator pits & walls will follow the forming and installation of rebar.

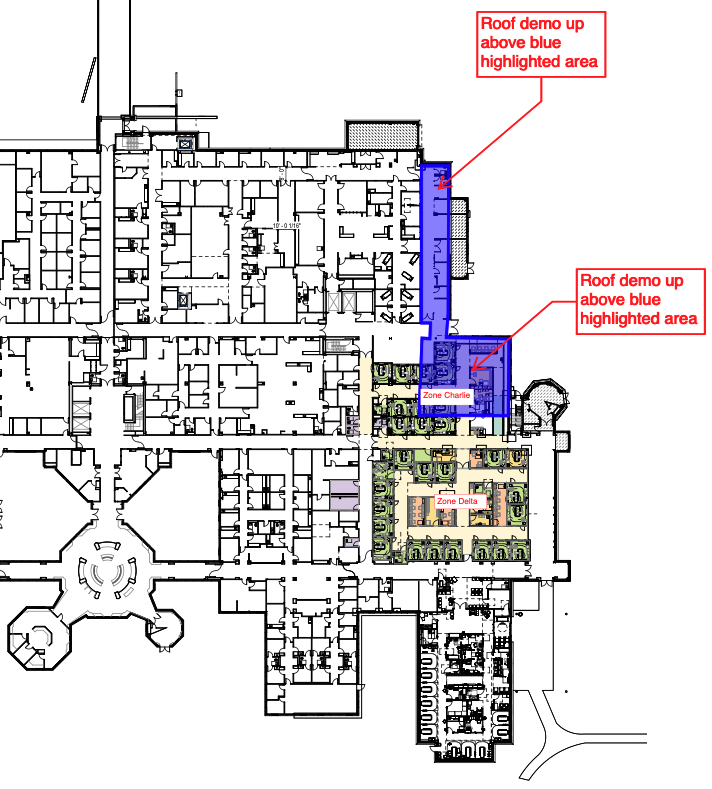

Roof demolition on level 2 started on May 7 and is expected to be completed by May 19. The demolition areas are above the existing ESD and adjacent areas (see map below). This work will bring noise and vibrations.

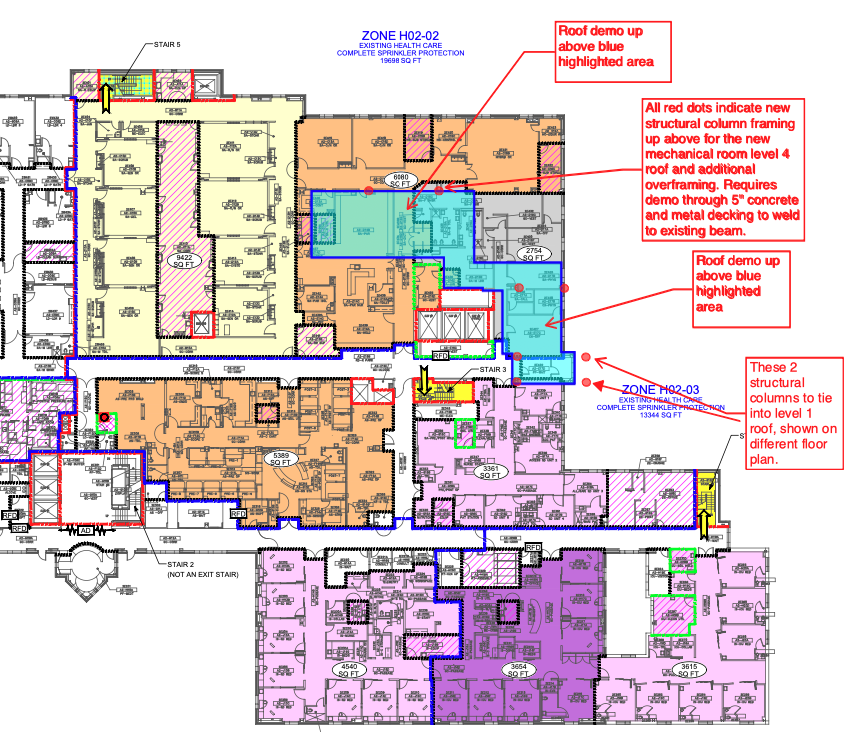

Roof demolition on level 3 will begin on May 21, or once the level 2 roof demo is complete. The demo will take about 2 weeks and should be complete around June 6. This will impact the OR area (see map below) and will bring noise and vibration.

Parking Update: Most of the ANMC Hospital’s east parking lot is fenced off for construction activities. Day parking is no longer available in the ANMC hospital east lot, except for limited ADA-accessible parking. The remainder of the available parking in this area is reserved for ESD patients.

Additional parking locations include the ANMC Patient Housing Parking Garage (north of the hospital), Denali Parking Garage (east of the hospital), and Flattop Mountain Parking Garage (south of the hospital). There is a marked pedestrian path from the Denali Parking Garage for all foot traffic between the garage and the ANMC hospital.
